Project Management
Time Schedules, Work Packages, Versioning, Documentation
Together with the project of creating my own Spatial Data Infrastructure I applied the techniques of project management.
This included breaking the project down into work packages, assigning responsibilities, defining a time schedule with deadlines and deliverables.

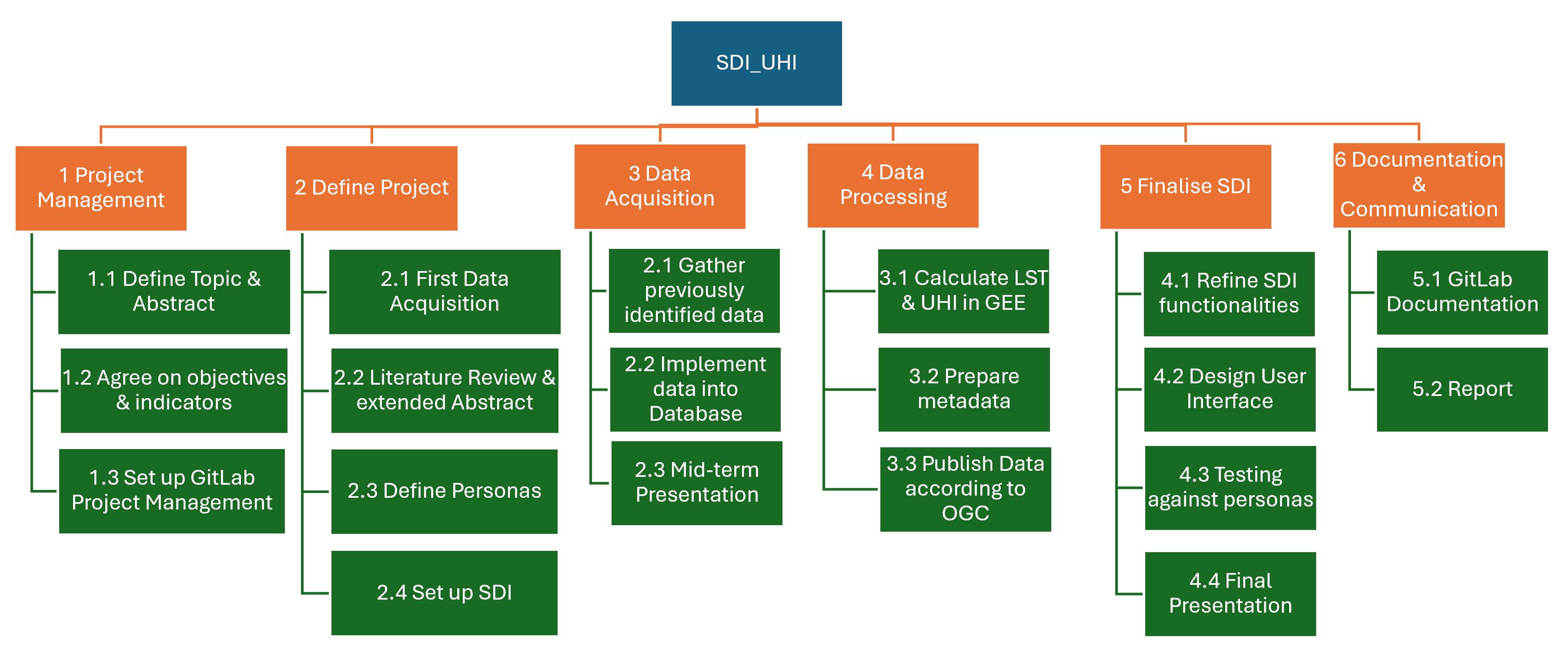

The project is divided into several work packages (Own Figure)
Each work package has its own subtasks and deadlines. With each deadline I defined a final product that needs to be completed by then.

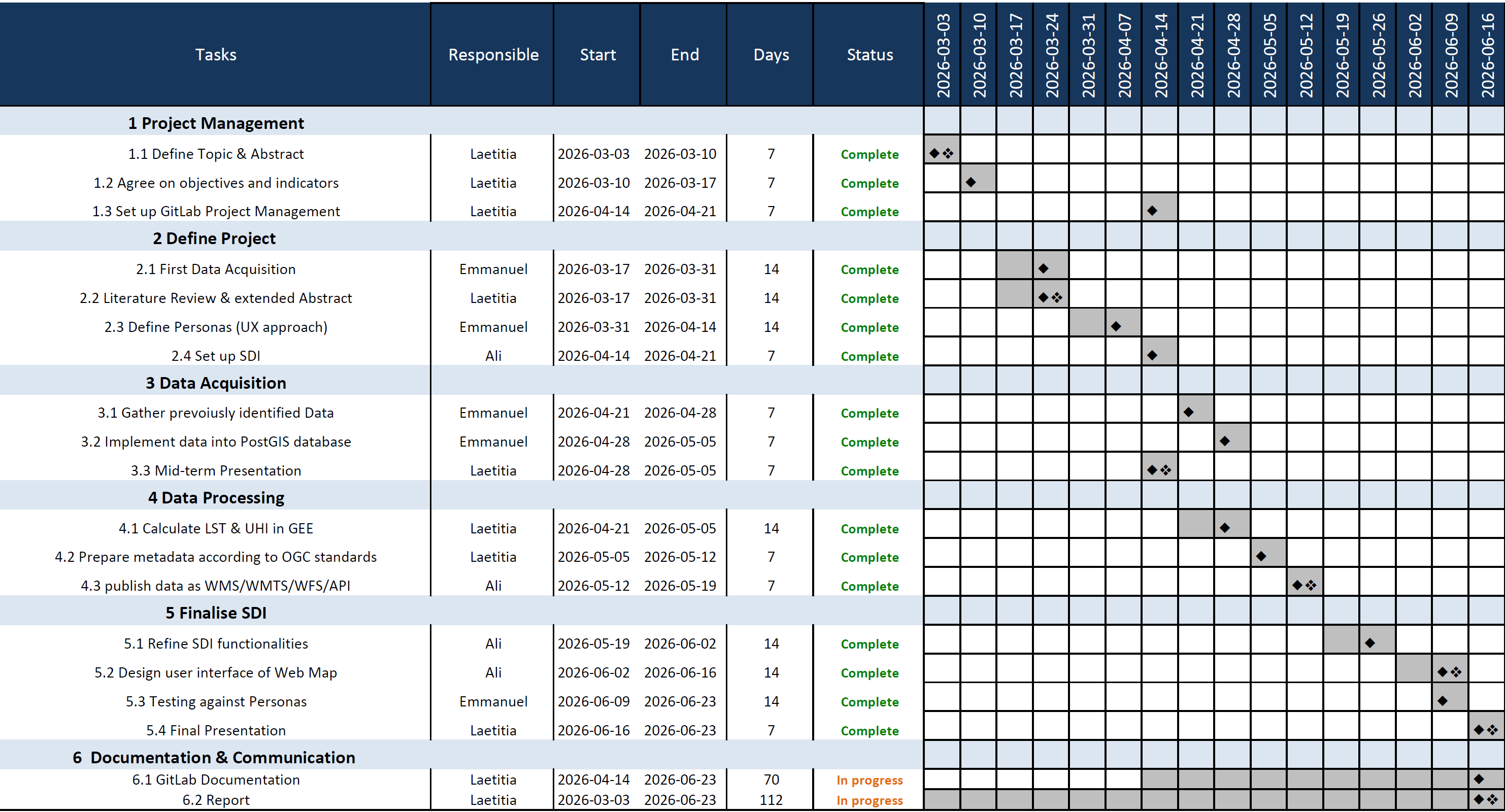

The Gantt Chart gives on overview of all deadlines (Own Figure)
To keep track of my work I used GitLab. In GitLab each task is assigned a date and milestone. The GitLab project also contains repositories for all files, code versioning and presentations. The Wiki is used to document the projects progress and work flow.

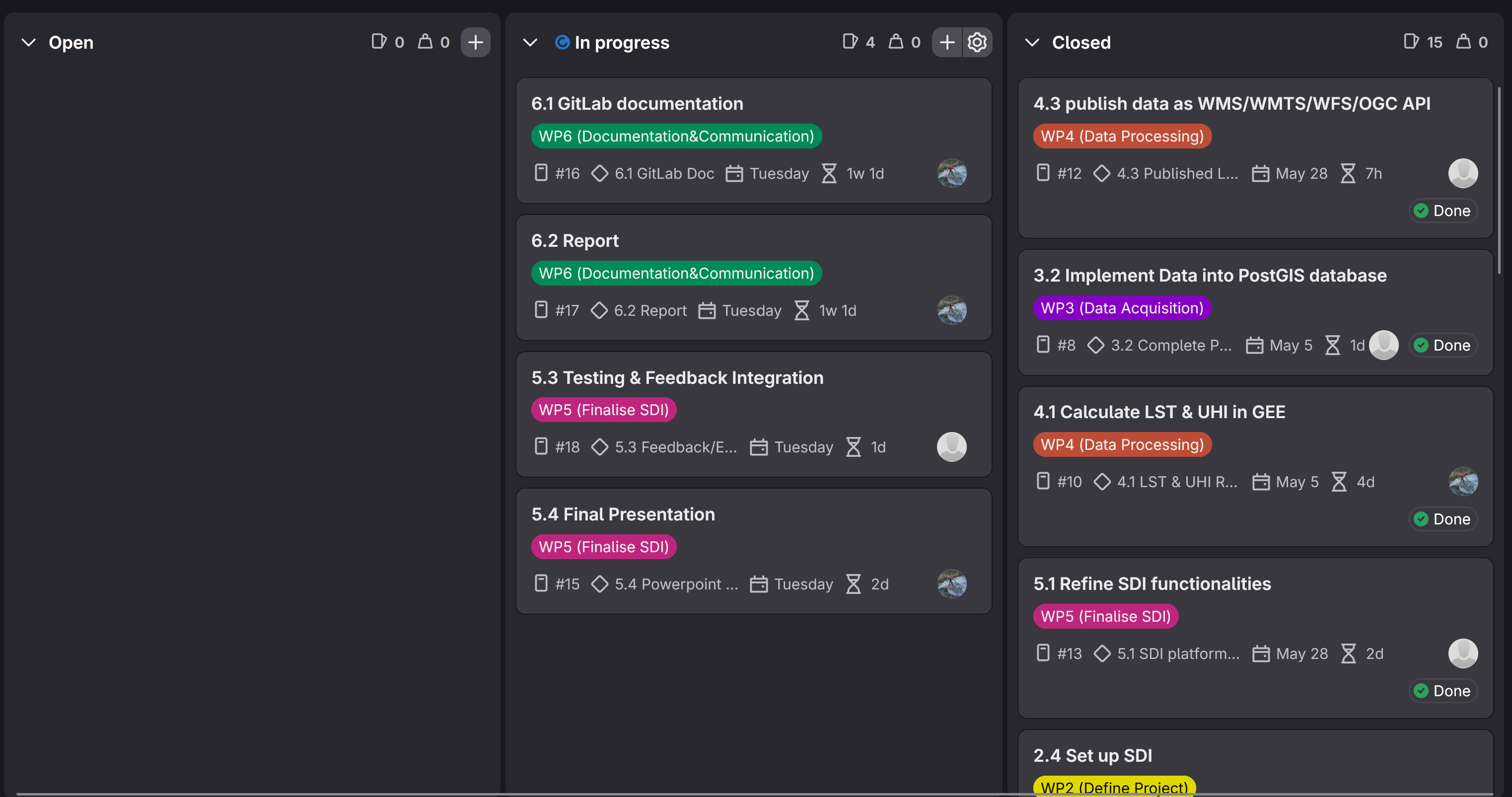

Issue board in GitLab highlighting the work progress
